Artemis II WDR Complete — But March Launch Is Off

šŸ“Œ UPDATE — February 25, 2026

The plot has thickened considerably: the SLS booster is now rolling back from the launch pad — and this time it may not be coming back. Under NASA Administrator Jared Isaacman, the agency is reportedly embracing the "best part is no part" engineering philosophy popularized by Elon Musk, applying it in the most dramatic way possible by removing the rocket from the Artemis program's architecture entirely. Space journalist Eric Berger was first to report the rollback, framing it as a deliberate, philosophy-driven decision rather than another technical delay. This marks a stark departure from previous NASA statements that positioned the helium issue as a solvable hurdle ahead of a future launch attempt. If confirmed as a permanent architectural change, it would represent the most significant restructuring of the Artemis program to date — and a potential death knell for the SLS rocket itself. šŸ”

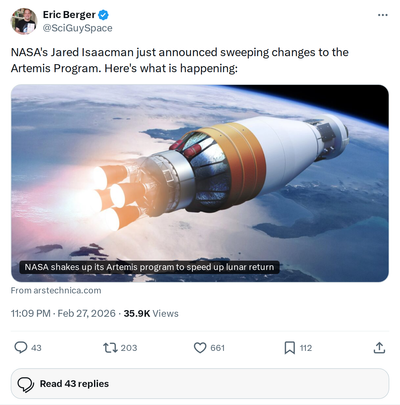

Eric Berger tweet: SLS booster rolling back as Isaacman-led NASA puts best part is no part into practice

šŸ“£ @SciGuySpace via X — Feb 25, 2026

30-Second Brief

The News: NASA successfully completed the second Wet Dress Rehearsal (WDR) for Artemis II on February 19, 2026, reaching the planned T-29 second hold — but a subsequent helium flow problem in the upper stage has forced a rollback and eliminated the March launch window.

Why It Matters: Artemis II is the first crewed mission to the Moon in over 50 years. The WDR success shows the rocket is fundamentally ready, but the new helium issue means the earliest realistic launch is now early April 2026.

Source: @NASASpaceflight on X

Artemis II Wet Dress Rehearsal Succeeds — Then a Helium Problem Grounds the March Launch

Published February 23, 2026 Ā |Ā  SpaceX & Space Industry

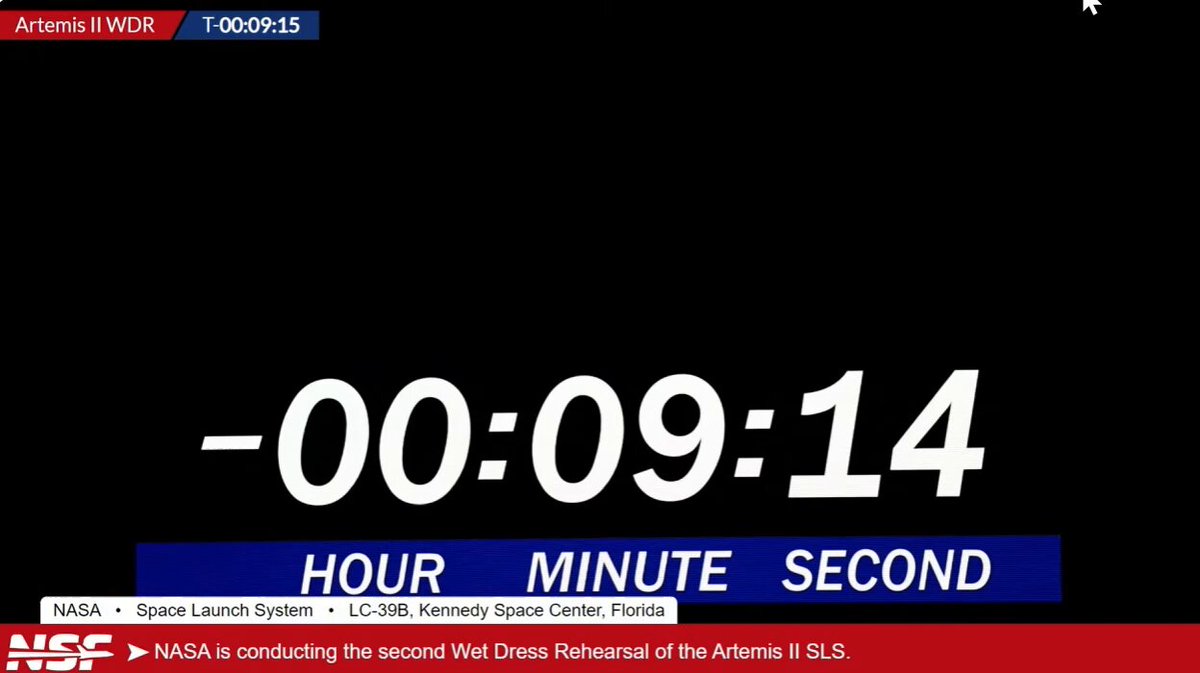

NASA hit a major technical milestone late on February 19, 2026, when the Space Launch System (SLS) rocket completed its second Wet Dress Rehearsal for the Artemis II mission — holding at T-29 seconds exactly as planned. It was a clean run after hydrogen leak repairs from the first WDR attempt proved successful. But within 48 hours, a separate issue with helium flow to the rocket's upper stage changed the picture entirely, forcing a rollback to the Vehicle Assembly Building and ruling out a March launch.

Here is a full breakdown of what went right, what went wrong, and where the mission stands now.

šŸ“Š Key Figures

Metric Value Context
WDR Hold Point Achieved T-29 seconds Exactly as planned
Propellant Loaded 700,000+ gallons Liquid hydrogen & liquid oxygen across core and upper stages
Hydrogen Leak Status Resolved QD fueling seal repairs from WDR 1 held — very minimal leakage observed
Crew Quarantine Start February 20, 2026 4 crew members entered quarantine in Houston
New Problem Identified February 21, 2026 Interrupted helium flow to ICPS upper stage during repressurization
March Window Status Eliminated Rollback to VAB required before relaunch attempt
Next Launch Opportunities April 1, 3, 4, 5, 6 Subject to repair outcome and Flight Readiness Review

The WDR: What Went Right

The second Wet Dress Rehearsal unfolded over two days and represented a genuine step forward for the program. The most significant technical hurdle coming in was the hydrogen leak that had plagued the first WDR attempt. Teams had replaced the quick disconnect fueling connection seals on the liquid hydrogen side, and the fix held — only very minimal leakage was observed during propellant loading. That is a meaningful engineering win.

Engineers successfully loaded more than 700,000 gallons of liquid hydrogen and liquid oxygen into the rocket's core stage and interim cryogenic propulsion stage (ICPS). The countdown then proceeded to T-33 seconds before pulling back to a planned hold at T-29 seconds — the defined success criterion for this rehearsal.

NASASpaceflight tweet: Artemis II WDR 2 counting, taking it down to T-33 seconds
Source: @NASASpaceflight — February 20, 2026

ā–¶ Watch Video on X

NASASpaceflight tweet: Artemis II WDR 2 complete, T-29 second hold as planned
Source: @NASASpaceflight — February 20, 2026

ā–¶ Watch Video on X

NASASpaceflight confirmed completion on X: the WDR was done, the planned hold achieved, and the data now flows to the Flight Readiness Review process. No launch date would be set until that review was complete — which, at the time, seemed like routine caution.

The Helium Problem: What Went Wrong Next

Overnight between February 20 and 21, engineers conducted a routine repressurization operation on the ICPS upper stage. During that process, they observed an interrupted flow of helium to the stage — helium being the inert gas used to pressurize propellant tanks and manage internal pressure systems. This is not a trivial issue. Helium systems are critical to safe propellant management during launch operations, and any anomaly requires full investigation before the vehicle can fly with crew aboard.

The consequence is direct: the SLS and Orion stack must roll back from Launch Complex 39B to the Vehicle Assembly Building at Kennedy Space Center for troubleshooting and repair. That rollback process — combined with repair time, re-stacking, and the required Flight Readiness Review — makes any launch attempt in March 2026 physically impossible. NASA Administrator Jared Isaacman confirmed the situation publicly, acknowledging that March is no longer on the table.

According to reporting from Spaceflight Now, the earliest realistic launch opportunities are now April 1, 3, 4, 5, and 6, 2026. Those dates remain targets, not commitments — they are contingent on the repairs going smoothly and the Flight Readiness Review clearing the vehicle.

The Crew

The Artemis II crew — NASA astronauts Reid Wiseman (Commander), Victor Glover (Pilot), Christina Koch (Mission Specialist), and Canadian Space Agency astronaut Jeremy Hansen (Mission Specialist) — entered crew quarantine in Houston on February 20, the same day the WDR completed. They are the first humans assigned to fly to the Moon since Apollo 17 in December 1972. The delay does not affect their readiness; crew quarantine protocols will adjust to the updated schedule.

šŸ”­ The BASENOR Take

Timeline

Early April 2026

Impact Level

High — Schedule Slip

Confidence in April

Moderate

Two competing narratives are at play here. On one hand, the WDR itself was a genuine technical success — the hydrogen leak that derailed the first attempt was properly fixed, the countdown ran clean to T-29, and 700,000+ gallons of cryogenic propellant were loaded without drama. That is real, meaningful progress for a rocket system that has faced its share of struggles. On the other hand, discovering a brand-new issue in the helium system within 48 hours of that success is a reminder of how many independent systems have to work flawlessly on a vehicle of this complexity.

The important thing to watch now is whether the helium issue is isolated — a faulty valve, a seal, a sensor — or whether it points to something more systemic in the ICPS. A clean repair and successful recheck could have the vehicle back on the pad in time for early April. If troubleshooting reveals deeper problems, that window could slip further. The Flight Readiness Review will be the real verdict.

šŸ“° Deep Dive

The Wet Dress Rehearsal is intentionally designed to expose exactly the kind of issues that have now surfaced — first the hydrogen leaks in WDR 1, now the helium anomaly found in the hours after WDR 2. That is the system working as intended. The alternative — discovering these issues during an actual launch attempt with crew aboard — is not an acceptable outcome. NASA's methodical approach, frustrating as the delays are, reflects the reality of flying humans on a vehicle that has not yet carried a crew.

The ICPS helium system issue is particularly notable because the interim cryogenic propulsion stage is the element responsible for sending the Orion capsule and its crew on the trans-lunar injection burn — the burn that sends them from Earth orbit toward the Moon. Getting that stage's pressurization systems right is not optional. There is no redundancy for a bad helium system at that point in the mission profile.

For context, the Artemis program has operated under severe schedule pressure since the first SLS launch in November 2022. Artemis I's uncrewed test flight took years longer than originally planned. Artemis II was subsequently pushed from 2024 to 2025 to 2026. Each delay adds cost and political scrutiny. A move from March to April is not catastrophic in the broader arc of the program, but it does narrow the margin for any further problems before the end of the current fiscal and political cycle in Washington.

The crew entering quarantine on the day of the WDR completion — a sign of how close NASA felt the launch was — underscores just how quickly this situation evolved. Within 24 hours, optimism about a March launch date turned into a confirmed rollback. That speed of change is a useful reminder for anyone following the program: in rocketry, the status can shift dramatically between morning and evening. The next major update will come once engineers have assessed the helium system in the VAB and NASA sets a formal Flight Readiness Review date.
